BT call centre Dundee

New BT Call Centre Dundee construction photos.

This new building was built at 2 Greenmarket on a piece of unused land. Staff moved into their new premises in December 2024 from their Ward Road offices that they have used since 1976.

BT call centre Dundee

New BT Call Centre Dundee construction photos.

This new building was built at 2 Greenmarket on a piece of unused land. Staff moved into their new premises in December 2024 from their Ward Road offices that they have used since 1976.

The site before work commenced – 18th of April 2022

Heavy machinery prepares the site – 23rd April 2022

A temporary ramp was built – 28th April 2022

Wooden hoarding blocked the view from street level but the multi-storey car park across the road gave great views – 26th May 2022

A “giant corkscrew” was used for the foundations a much quieter option than traditional piling – 26th May 2022

The modest car park can be seen in this image – 6th June 2022

The giant corkscrew had to be moved all around the site – 15th June 2022

The foundations of the central core – 17th August 2022

Steel reinforcing cables for the central core – 7th September 2022

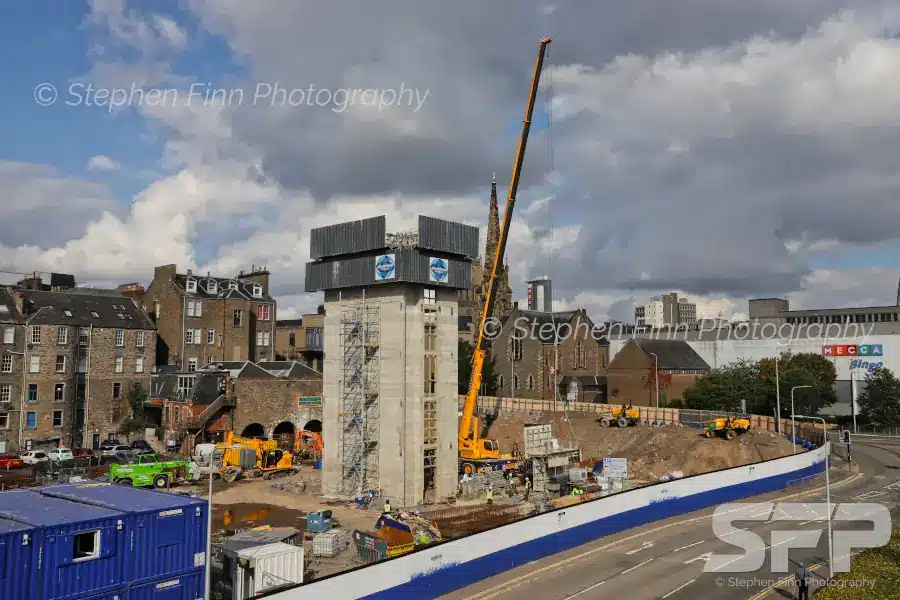

Work begins on the central core – 10th September 2022

The central core was made by Stephenson RC Frames – 20th September 2022

The tower was made in sections and the frame was moved upwards for each section – 29th September 2022

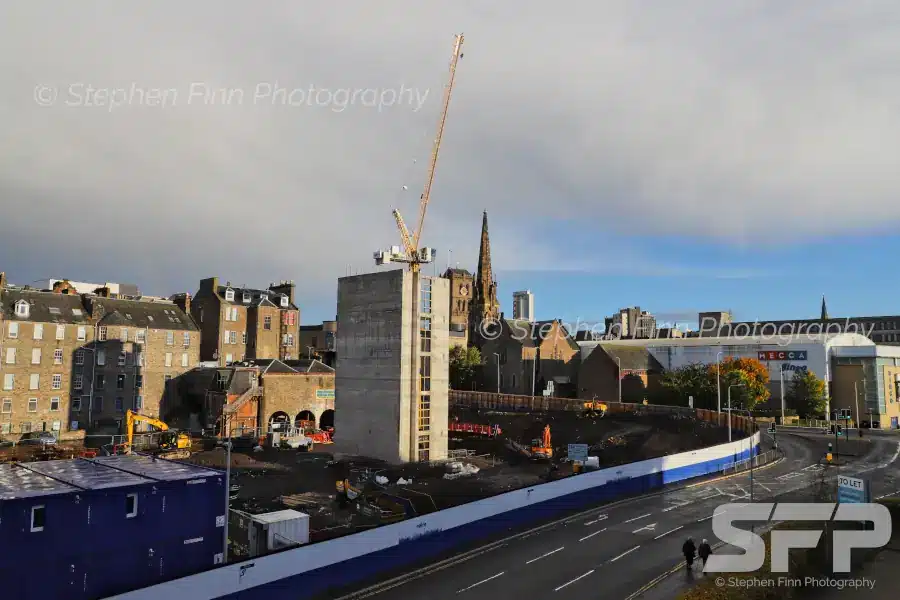

The completed reinforced concrete core – 16th October 2022

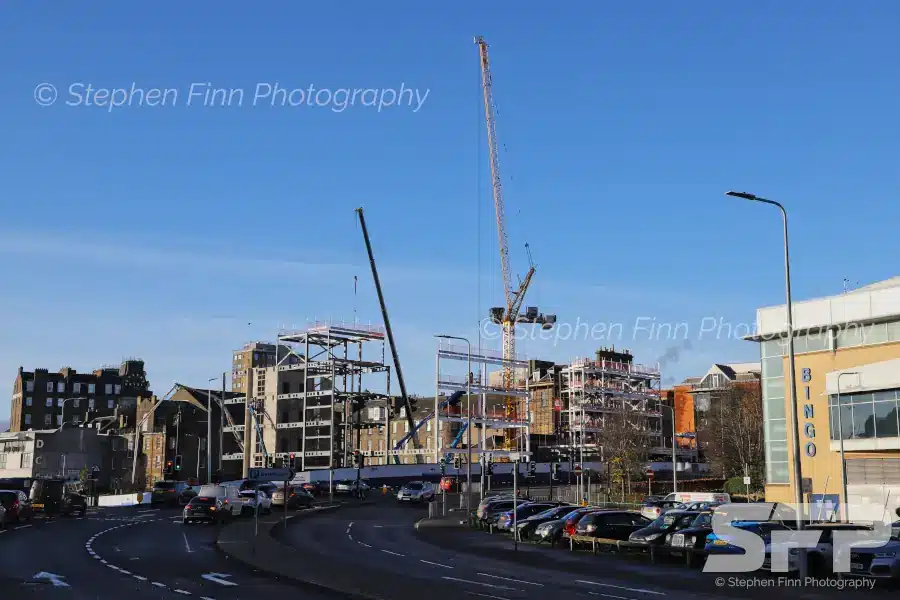

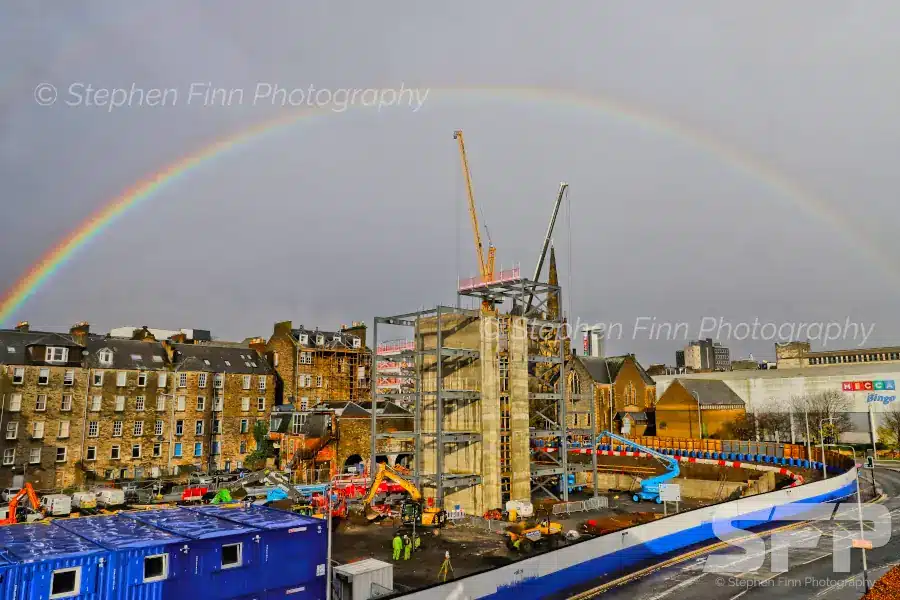

The start of the metal framework on a wet day – 22nd November 2022

A closer view of the steel frame – 29th November 2022

The BT office building is on the left and a PBSA is on the right – 29th November 2022

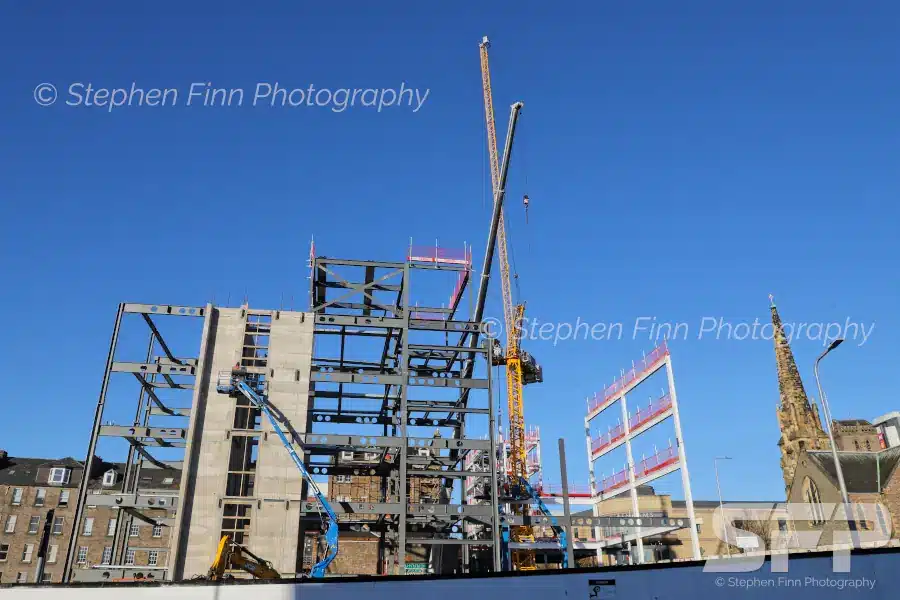

The steel framework begins to take shape – 15th December 2022

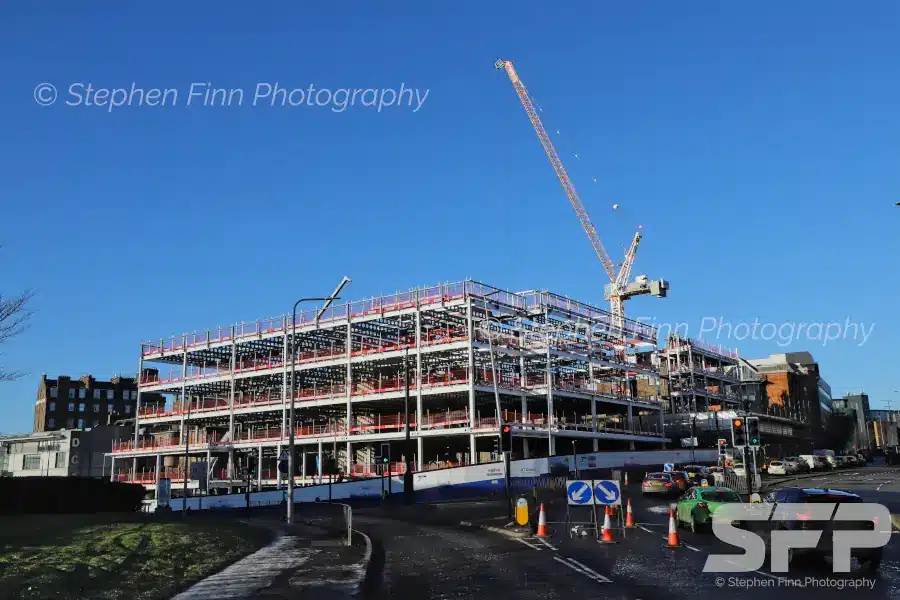

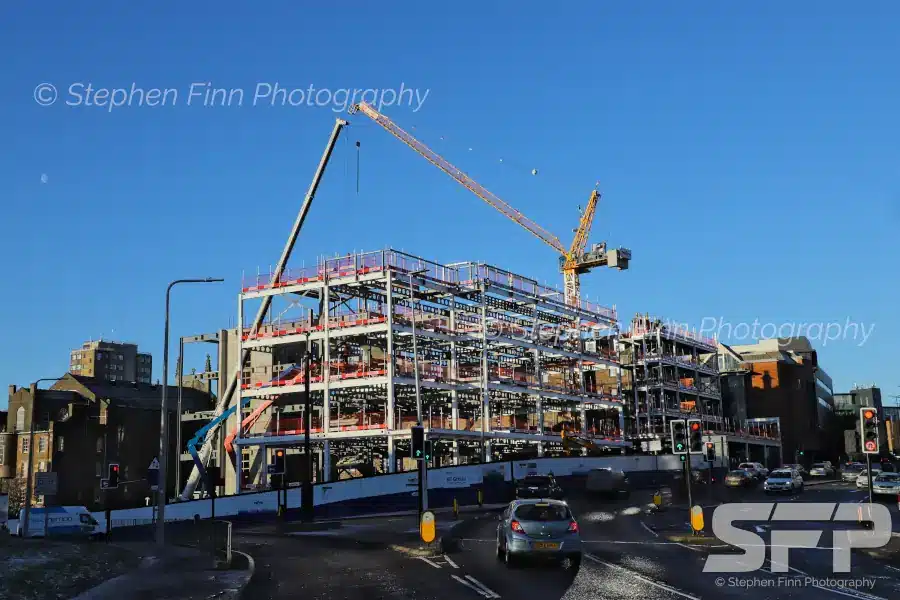

A wider view – 20th January 2023

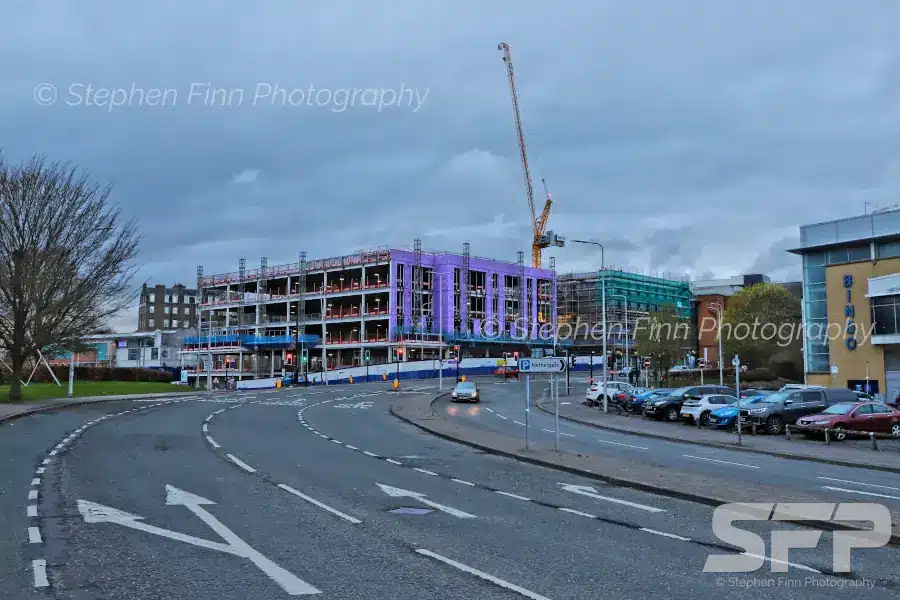

The completed framework with stacks of steel decking in position – 25th January 2023

BT call centre Dundee

The steel frame with the steel decking of the floors in place – 7th March 2023

BT call centre Dundee

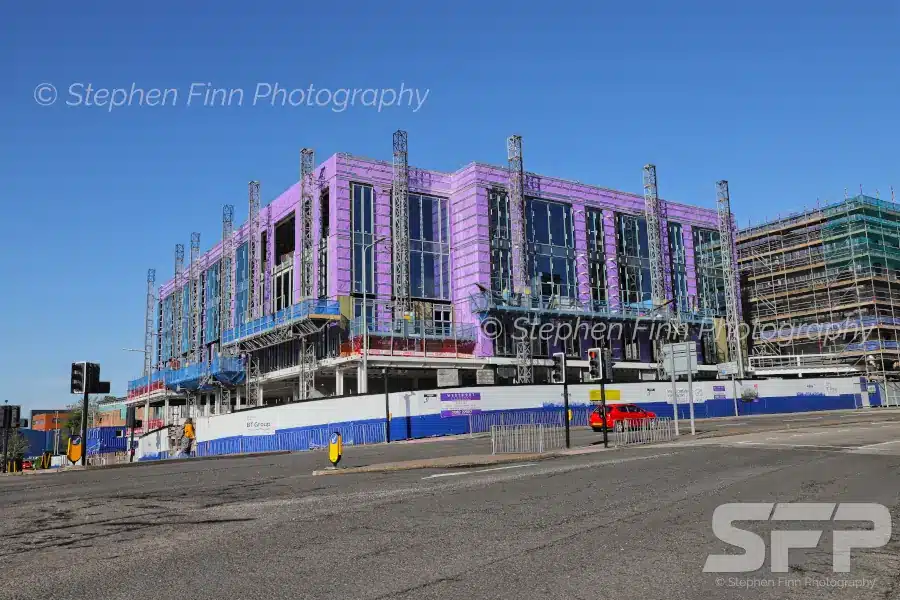

Purple Siniat Weather defence being fitted – 13th April 2023

BT call centre Dundee

Great that this gypsum-based external sheathing board comes in BT purple – 9th May 2023

BT call centre Dundee

The Weather Defence was later covered in a layer of insulation – 23rd August 2023

BT call centre Dundee

Then a layer of brick on the lower levels- 18th September 2023

BT call centre Dundee

And cladding on the upper levels – 20th September 2023

BT call centre Dundee

The exterior almost complete – 29th September 2023

BT call centre Dundee

The exterior with some of the mast climbers removed – 14th October 2023

BT call centre Dundee

Many bags of soil were lifted onto the roof – 28th November 2023

BT call centre Dundee

Work has begun on the fit out of the interior – 27th June 2024

BT call centre Dundee

BT Group signage added to the completed building – 5th December 2024

BT call centre Dundee

My favourite viewpoint of the completed building – 16th December 2024
